January – April 2026

Crossing More Things Off the List.

January - 2026

We started on the roof in March 2025 with installing the underlayment. We used the Polystick XFR WUI line, uniquely designed for fire resistance, and added an extra layer under the future solar panels.

The Mission clay tiles were supposed to soon follow, but got held up by many heavy rainy days that spring and then months of manufacturer delays. MCA Tiles and DMR Roofing were great about working through order hiccups and getting us through delivery of our beautiful tiles that were worth the wait.

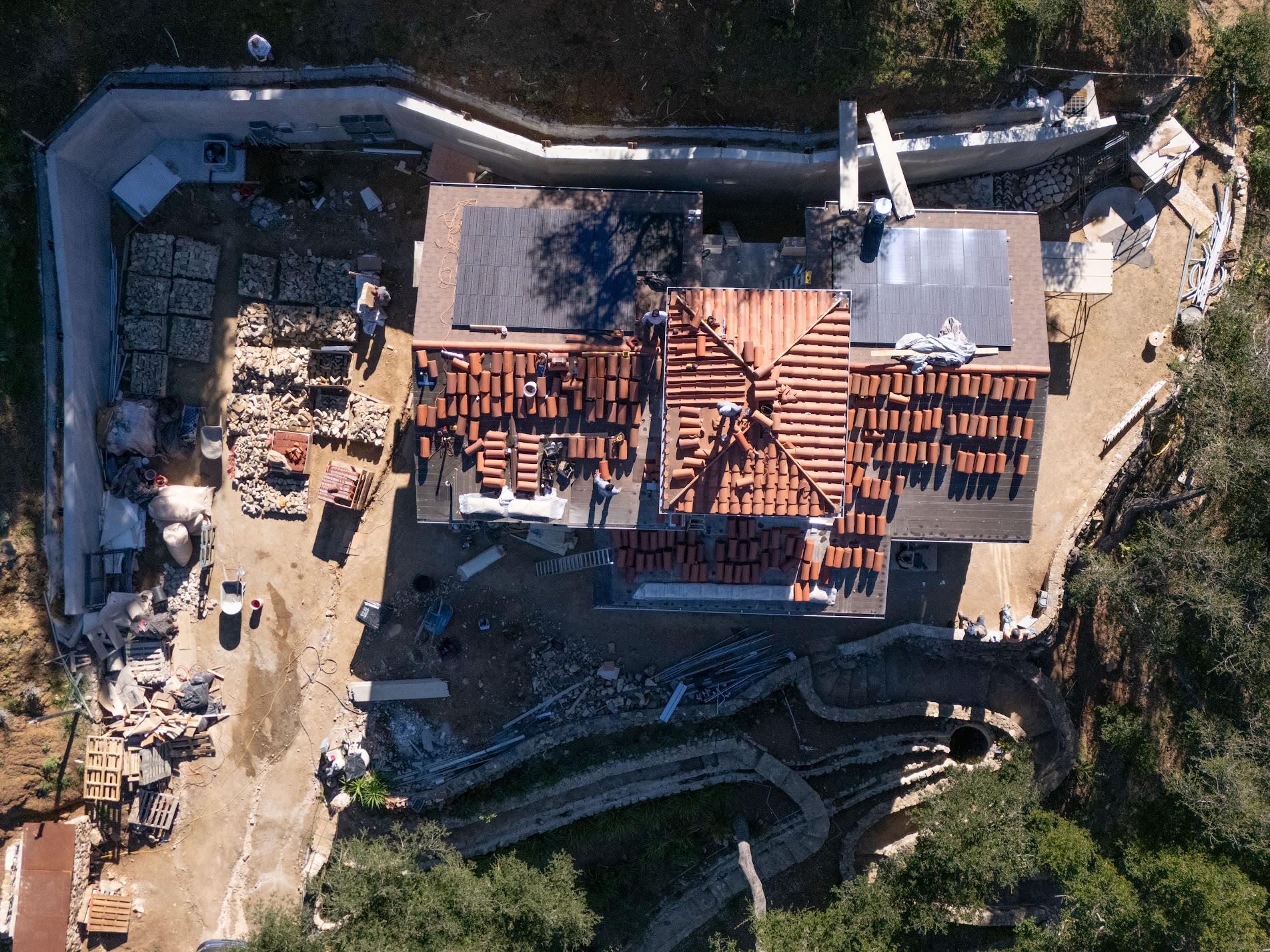

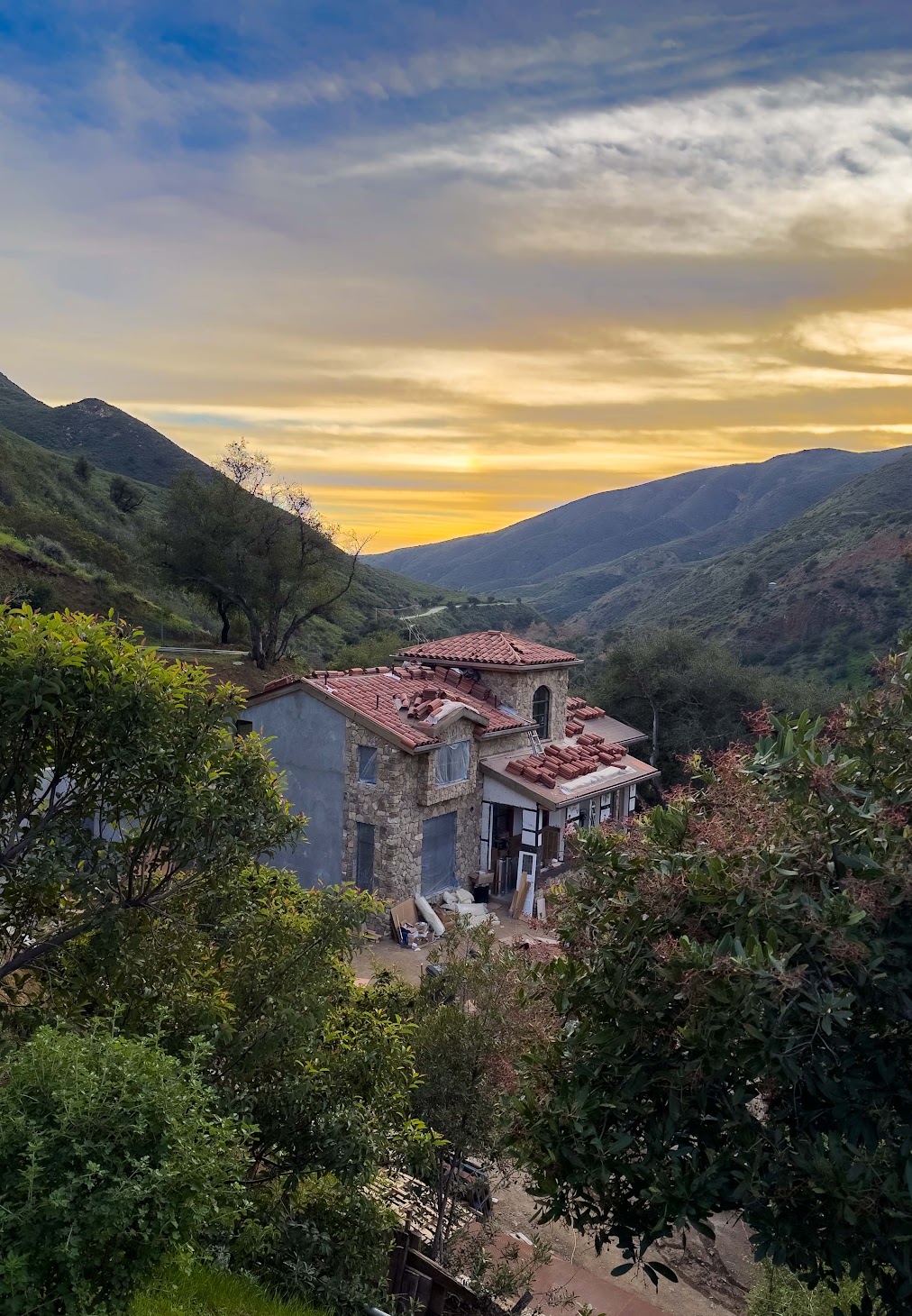

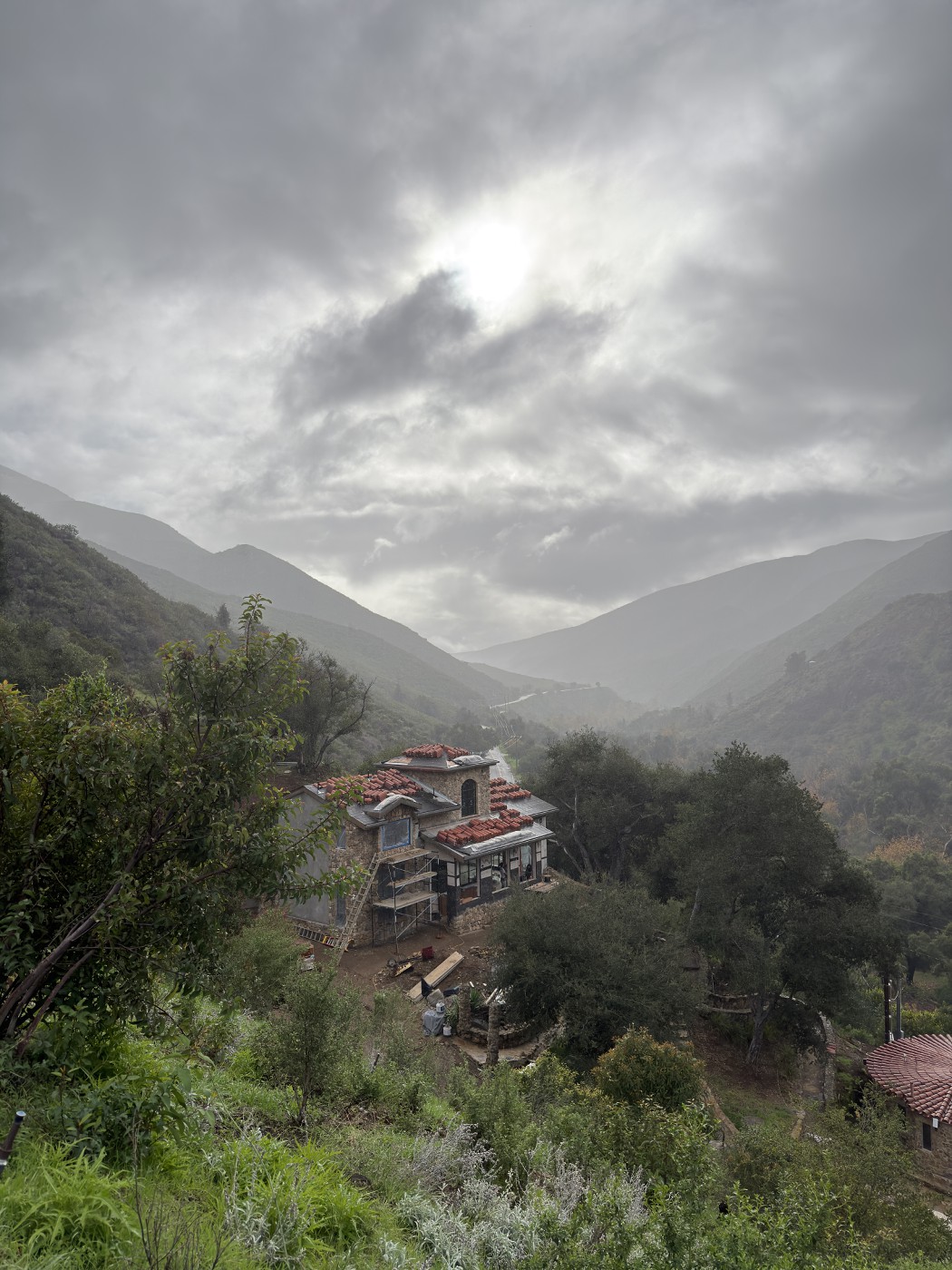

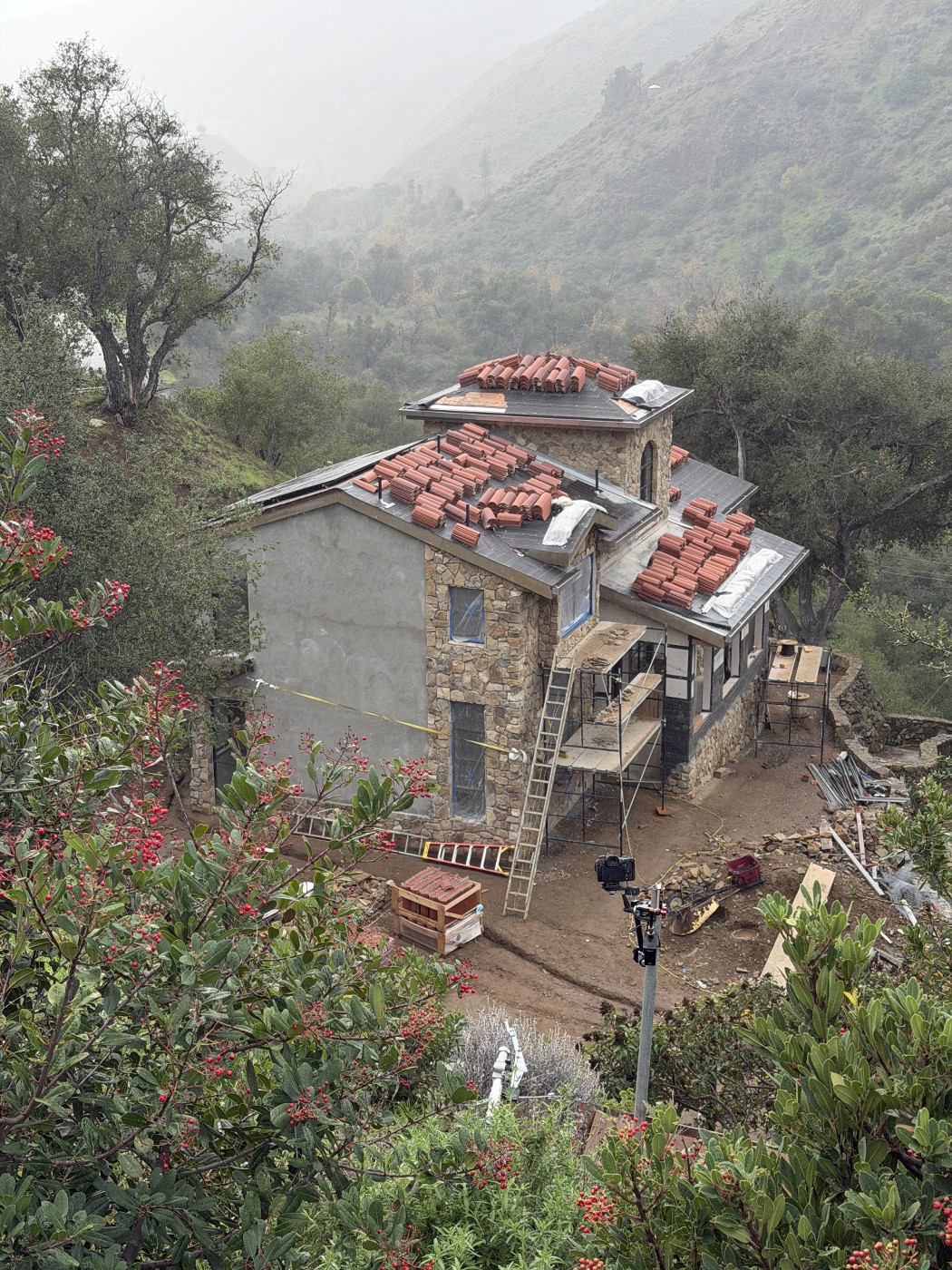

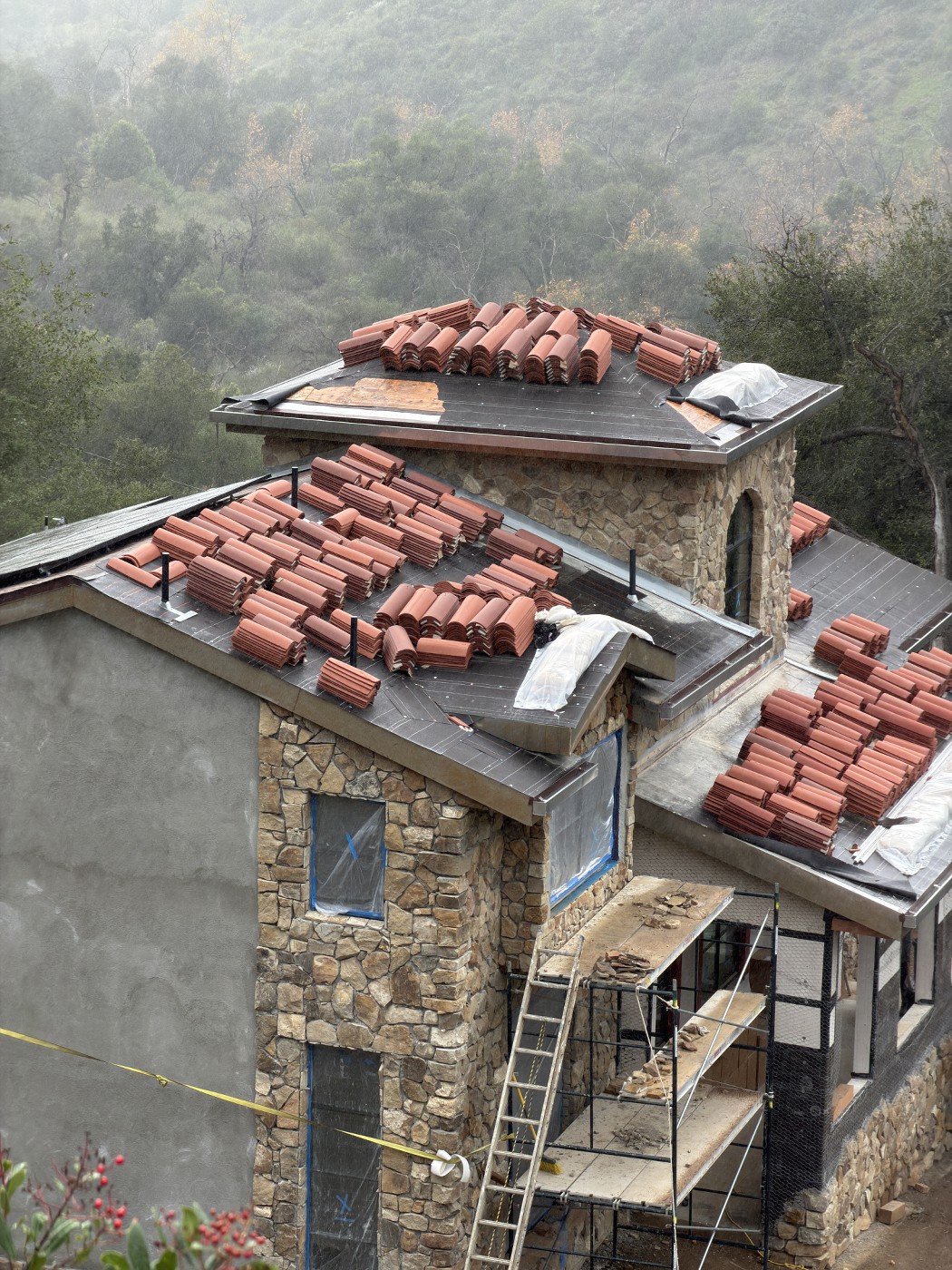

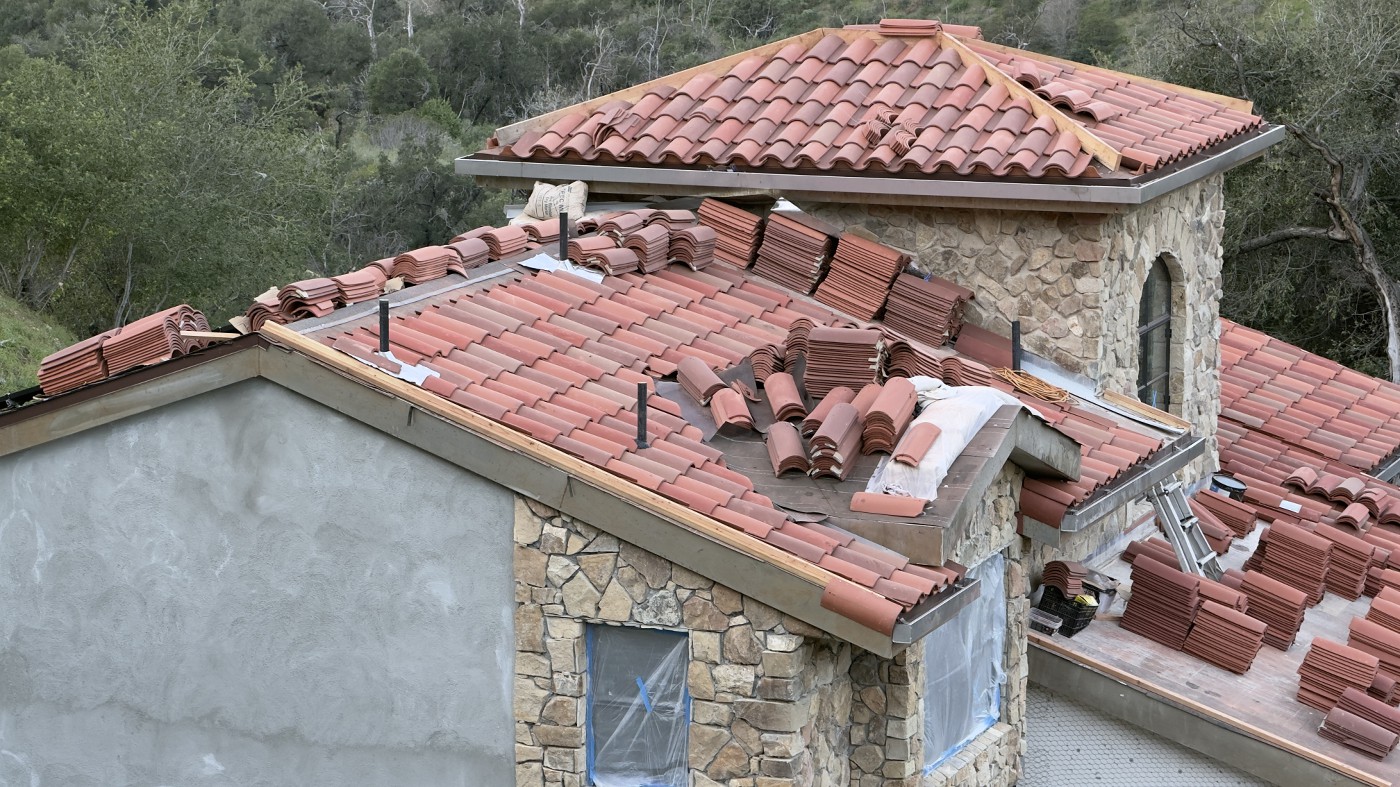

Tile installation work finally started at the end of December despite wet weather, and the tiles were finished in January 2026. The small finishing jobs, including the rain gutters that we had made out of stainless steel – rusted and sealed to match other finishes – took until April.

We were impressed by how the roofers moved across the roof as if it were flat ground. One explained he wears special roofing shoes that cost around $500, last him 8 to 12 months, and use maximum surface contact and specific grip design to prevent slips on wet and oily surfaces.

Daniel Martinez, who owns the roofing company, is the nicest guy. He was always humble, highly accountable, and open to our ideas – a rare and welcome combination in a stressful rebuilding process.

Summary: Rain and a months-long wait for clay tiles delayed our roof completion, but the tile installation finished in January, and the gutters in April.

Permanent Power Pole Connected | Temporary Pole Rental Ends

Fire rebuilders who lost their electricity infrastructure during the fire must rent a temporary power pole to get grid power during pre-construction and construction, In order to get a temporary power pole, the County required us to first either get a building permit or a temporary housing permit.
We obtained our temporary housing permit in 2020 when our tiny house on wheels was delivered – about four years before getting our building permit, so this was our route to temporary power.
Our pole rental from Andy Gump cost about $50 a month, our electric utility SCE added to that expense at first by only offering a premium high construction rate. We were able to negotiate a lower rate with SCE by contacting the CPUC customer advocate and reasoning that wildfire survivors trying to rebuild their homes should not be subjected to commercial or otherwise more onerous rates than regular residents.
In January 2025, while heavy winds were causing fires to burn all over LA County, the gusts blew down our temporary pole. While getting it repaired, now that our rebuild was in framing, we began working with SCE to get our permanent pole.
Diane learned from the SCE rep that their most fire resistant above ground poles are made of fiberglass, so we contacted the utility’s fiberglass pole vendor and put in an order.  Our pole was delivered in spring 2025, but the County required all the rough electrical work to be safe before energizing.
Finally on January 9th, 2026, SCE  energized our permanent power pole, ending our 6 1/2 year temporary power pole rental expense and marking a major milestone in rebuilding our lives..

Another “quick” way to remove the temporary pole

Early Wildflowers Are in Bloom

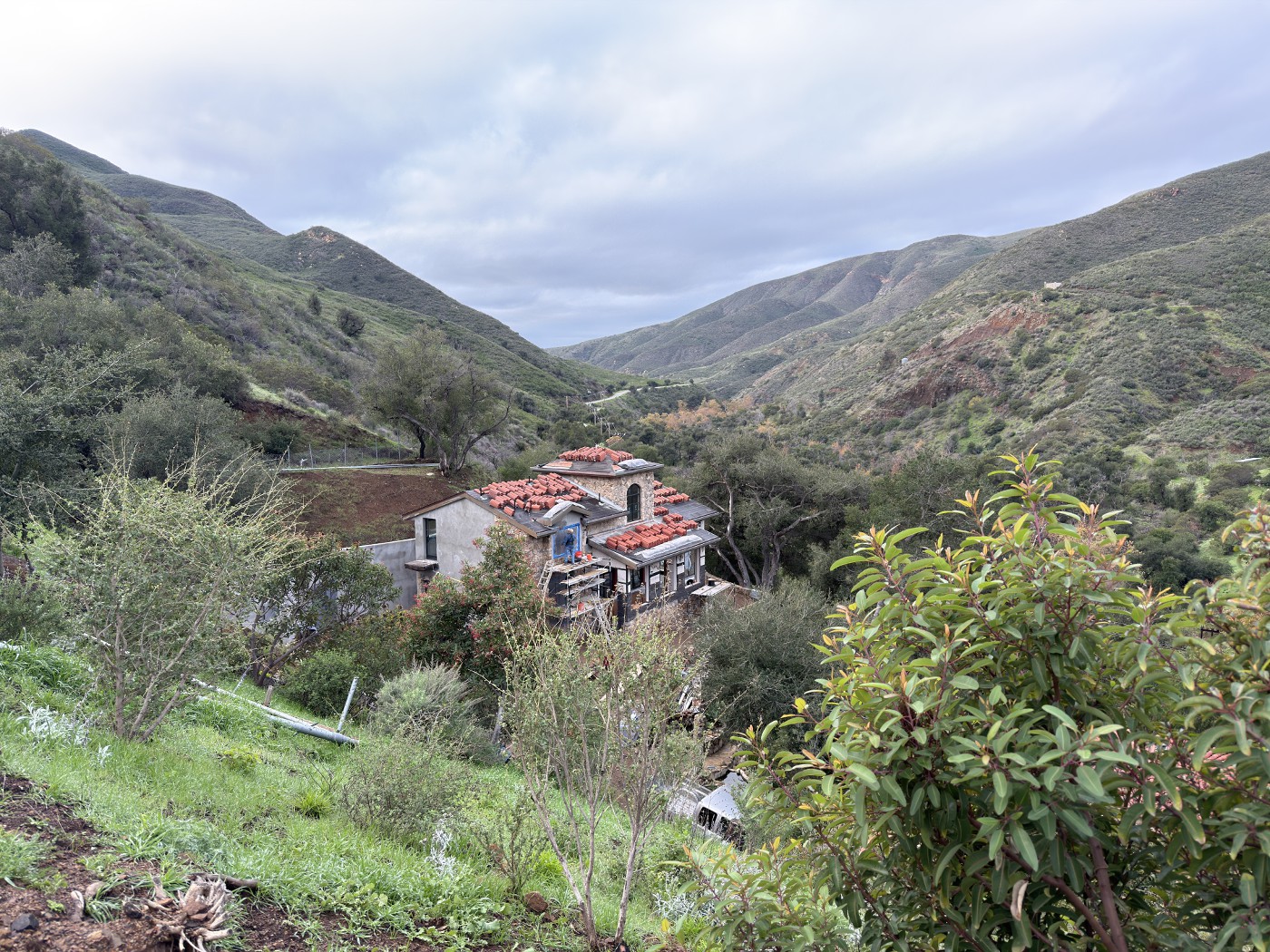

After the soaking rains of November and December 2025, the hills in the Santa Monica Mountains and on our property are greening up, and the wildflowers are showing up early this year. Here’s what’s blooming on the land right now.

Wood Floors

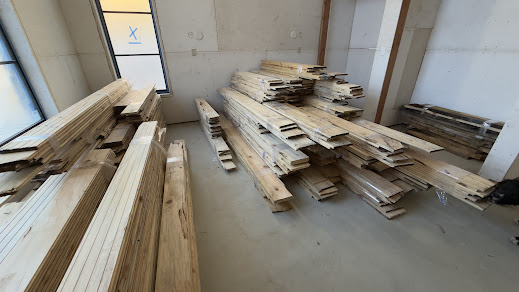

The floors in our new home are made from our fire-destroyed trees that that got cut down in 2019 and that we milled into planks onsite with a portable mill in 2021. A local mill made planks into tongue-and-groove boards.

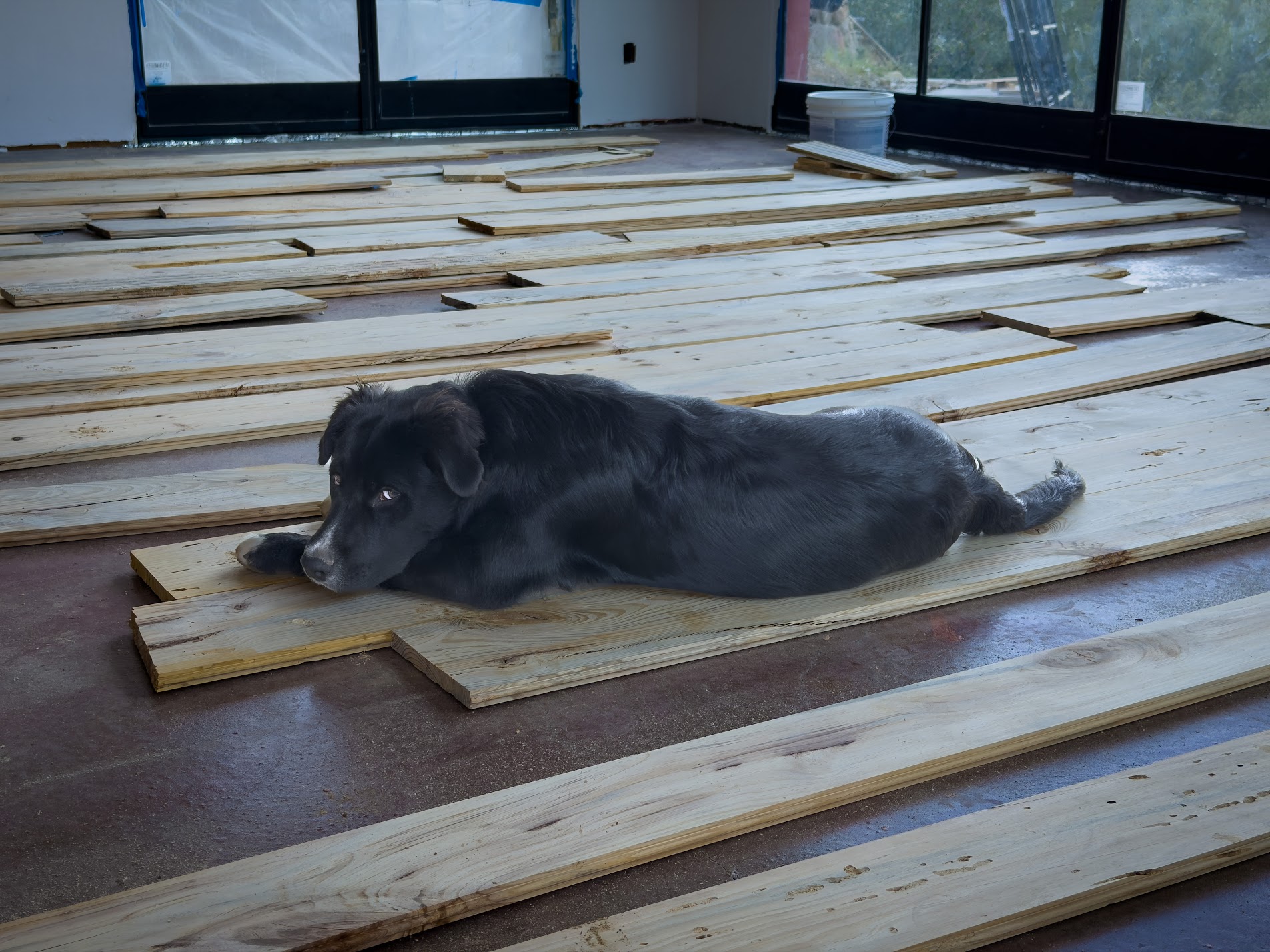

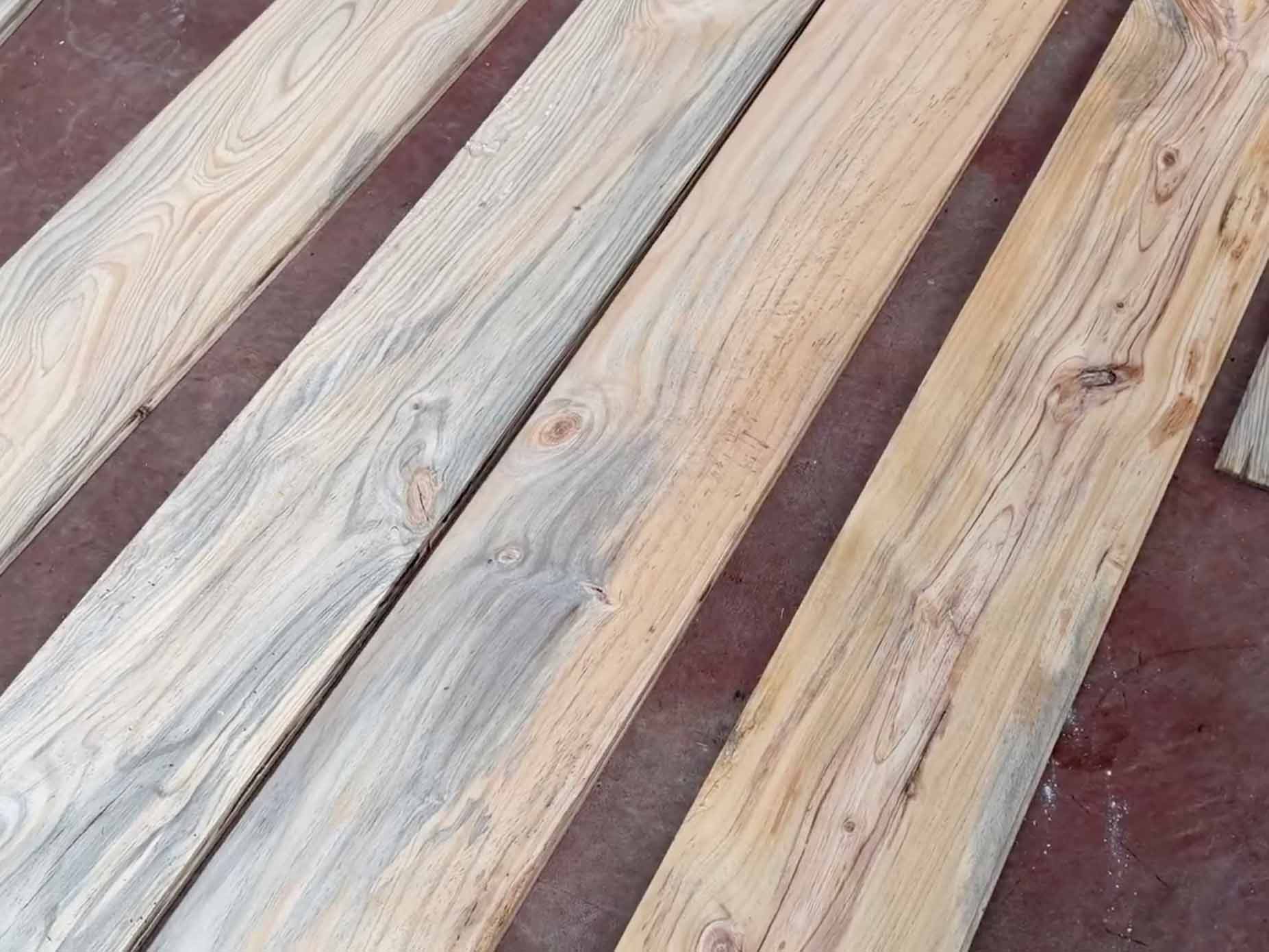

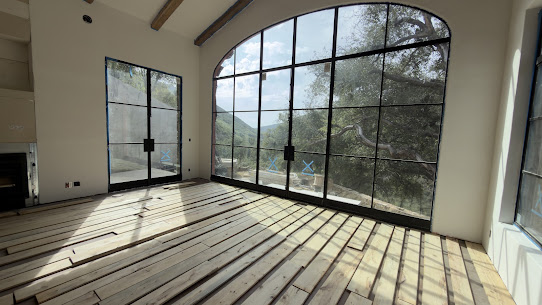

Once the flooring was delivered, we first sorted it by size, color and quality, and then selected boards to lay into a pattern in each room before fixing any of them in place. Choosing from so many patterns and colors took time, but helped transform the tragic loss of the trees into an artistic, joyous experience.

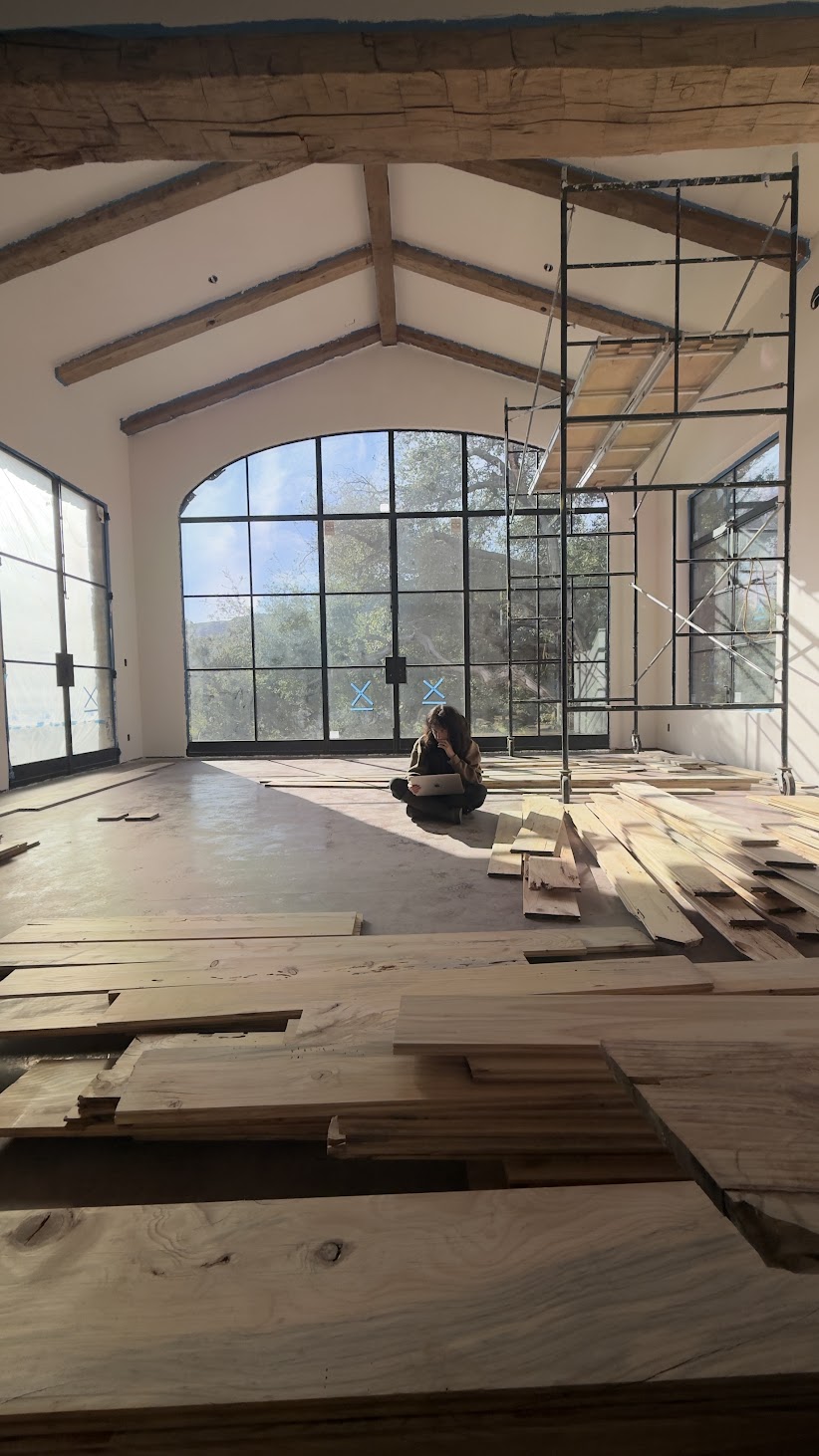

Diane spent days sorting and selecting the boards piece by piece, sometimes with help and sometimes on her own.
Although the slab was new and thick, as an extra precaution, we added a non-toxic moisture barrier made by Bona.

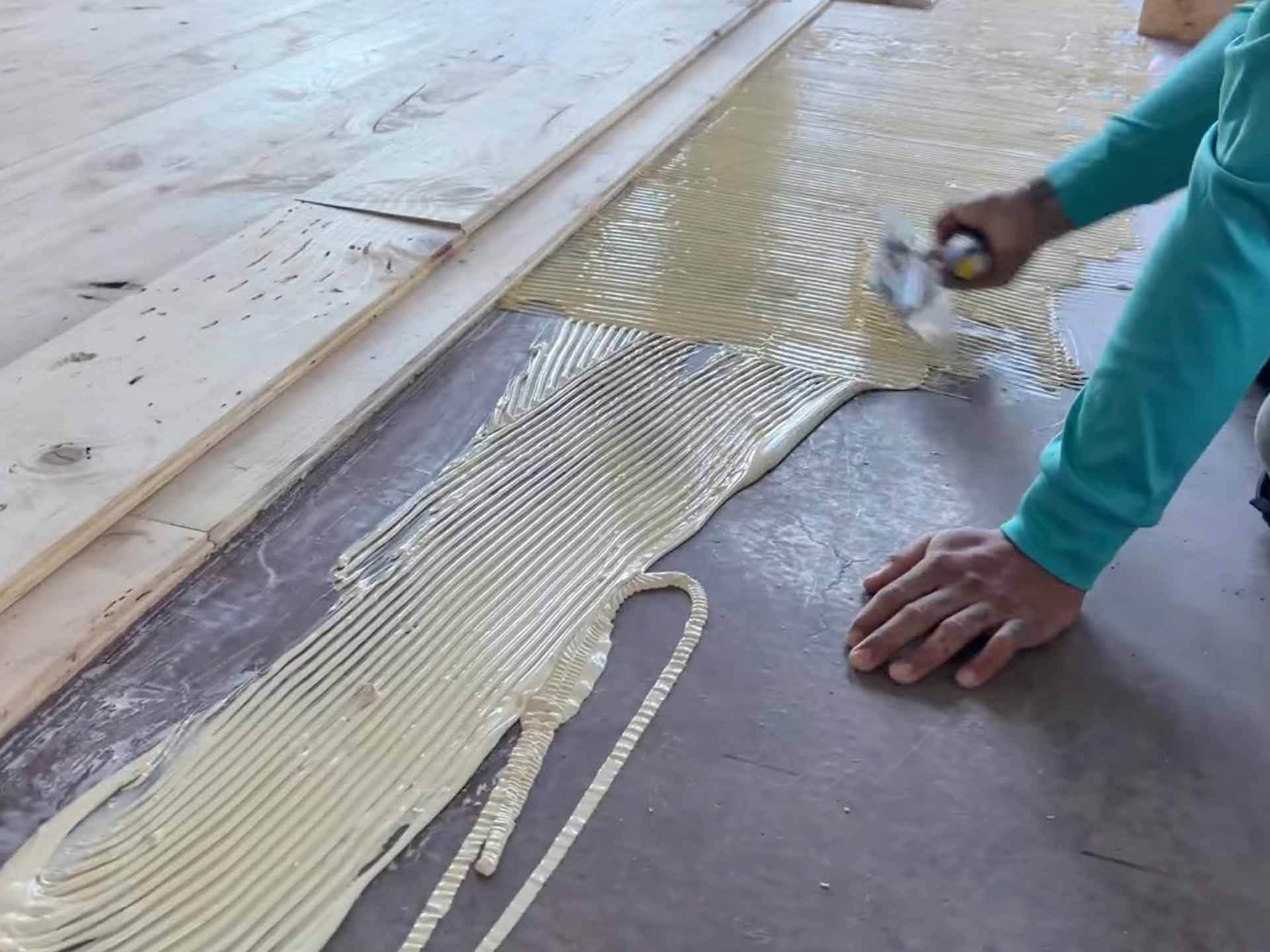

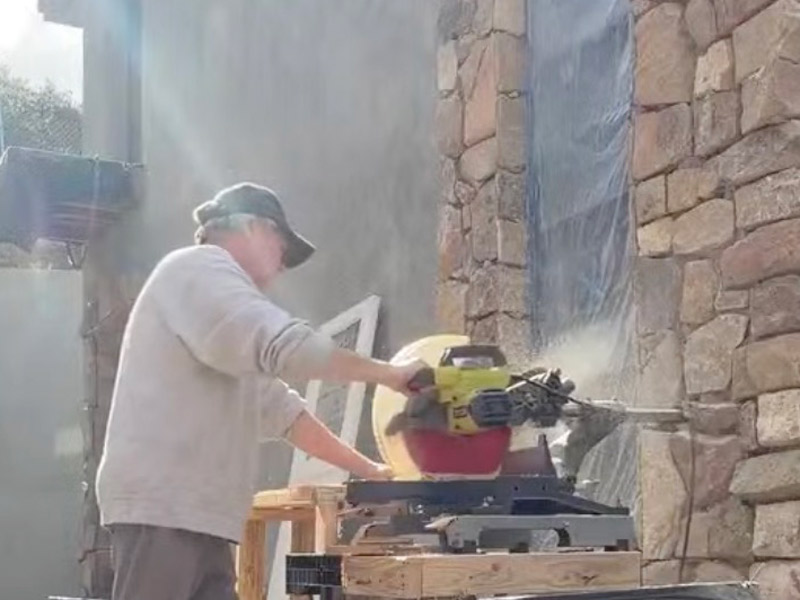

Then came time to cut the boards into their final lengths and glue them down with Bona’s non-toxic adhesive, which we did with the support of our wonderful building crew.

Diane then filled some of the bigger holes and knots with either clear epoxy or wood glue with sawdust made from cutting the planks.

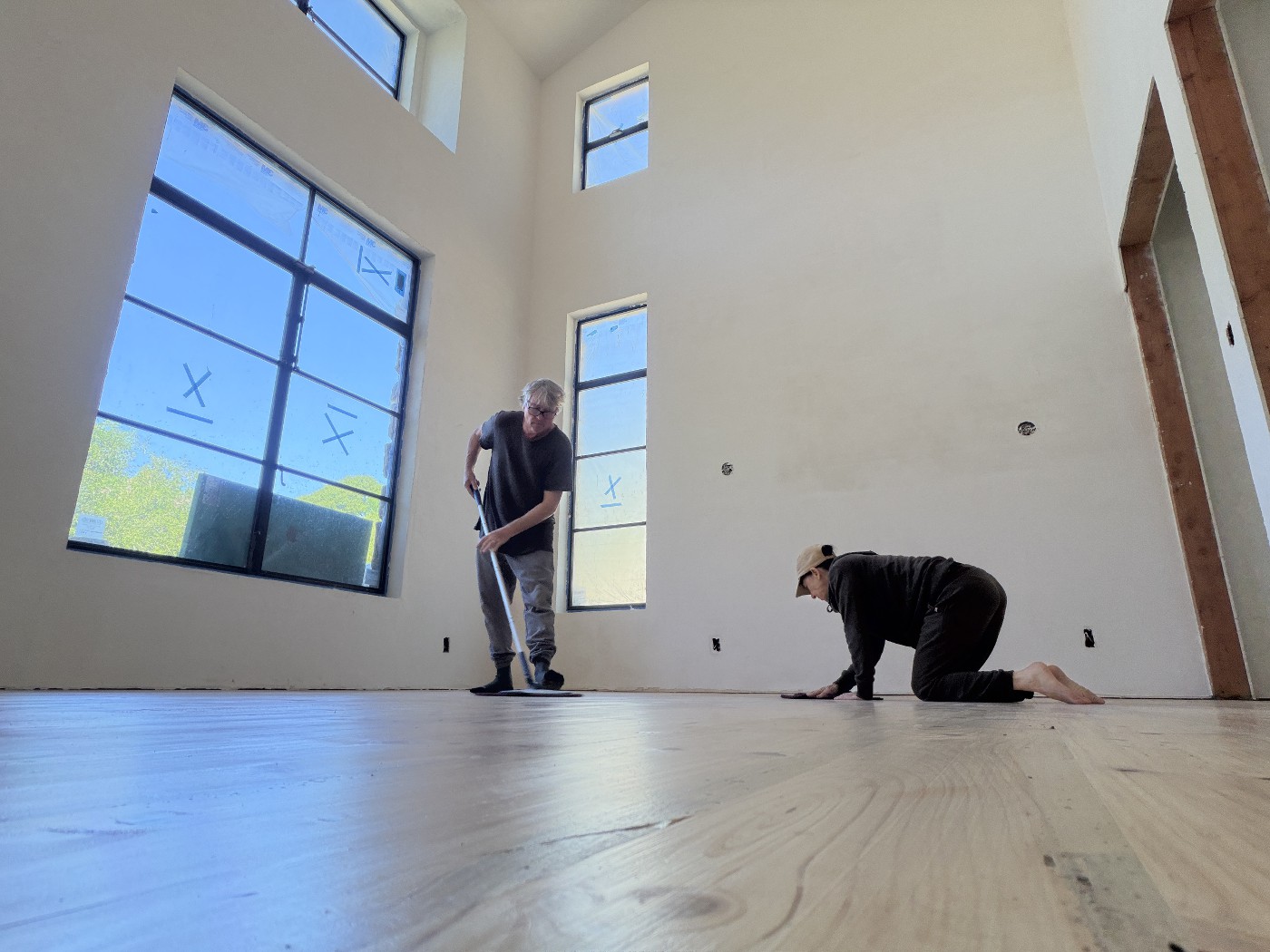

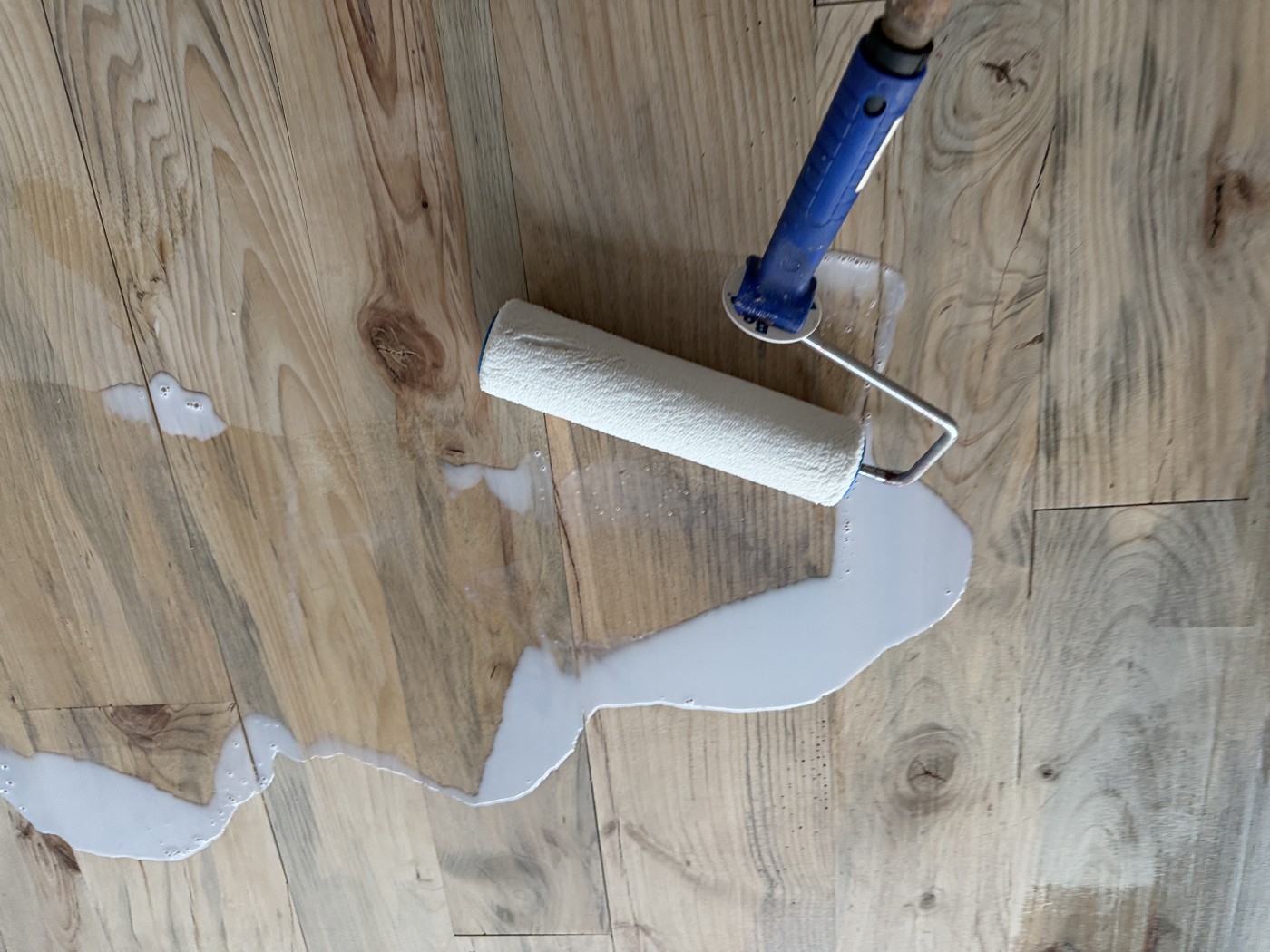

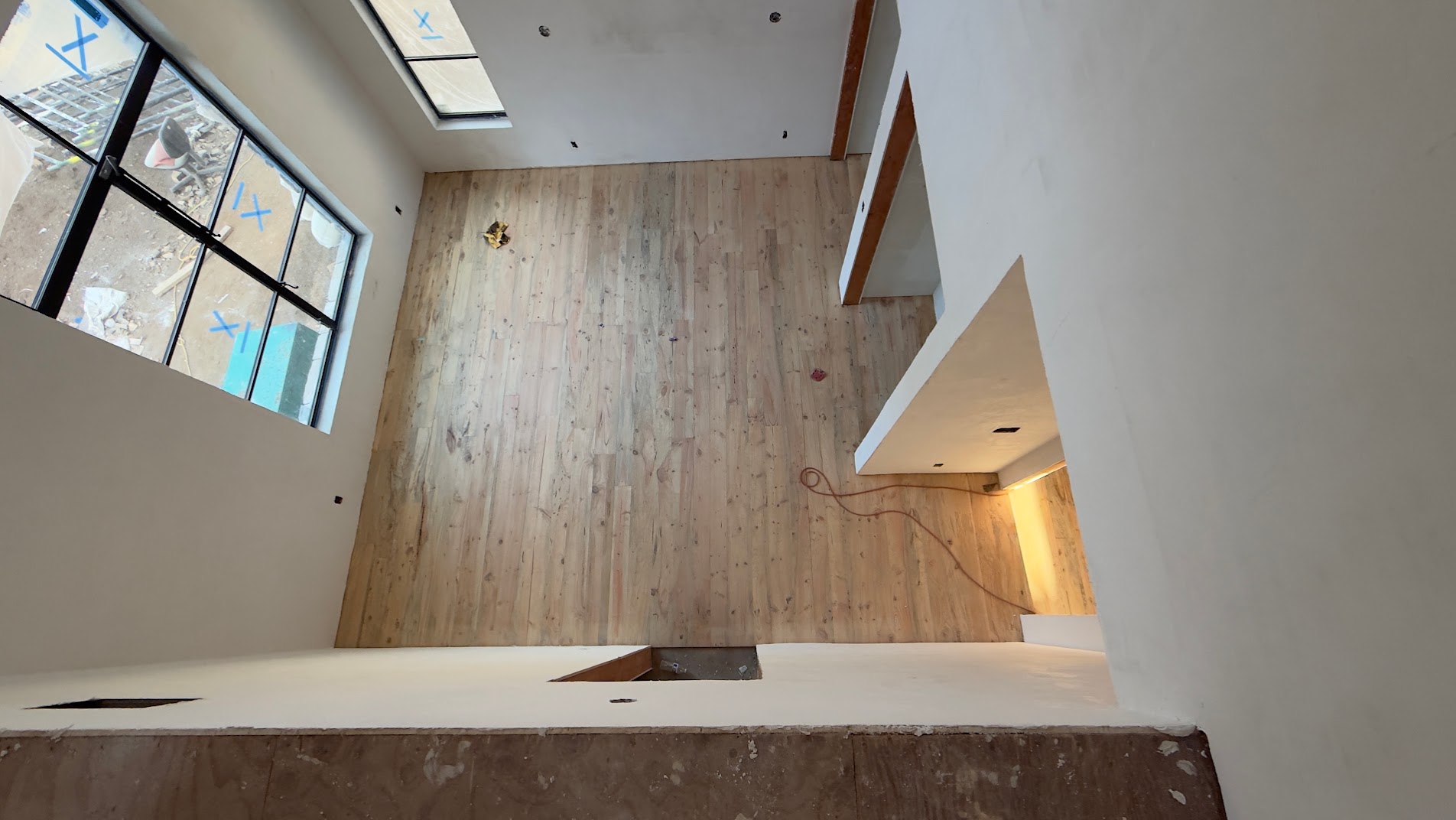

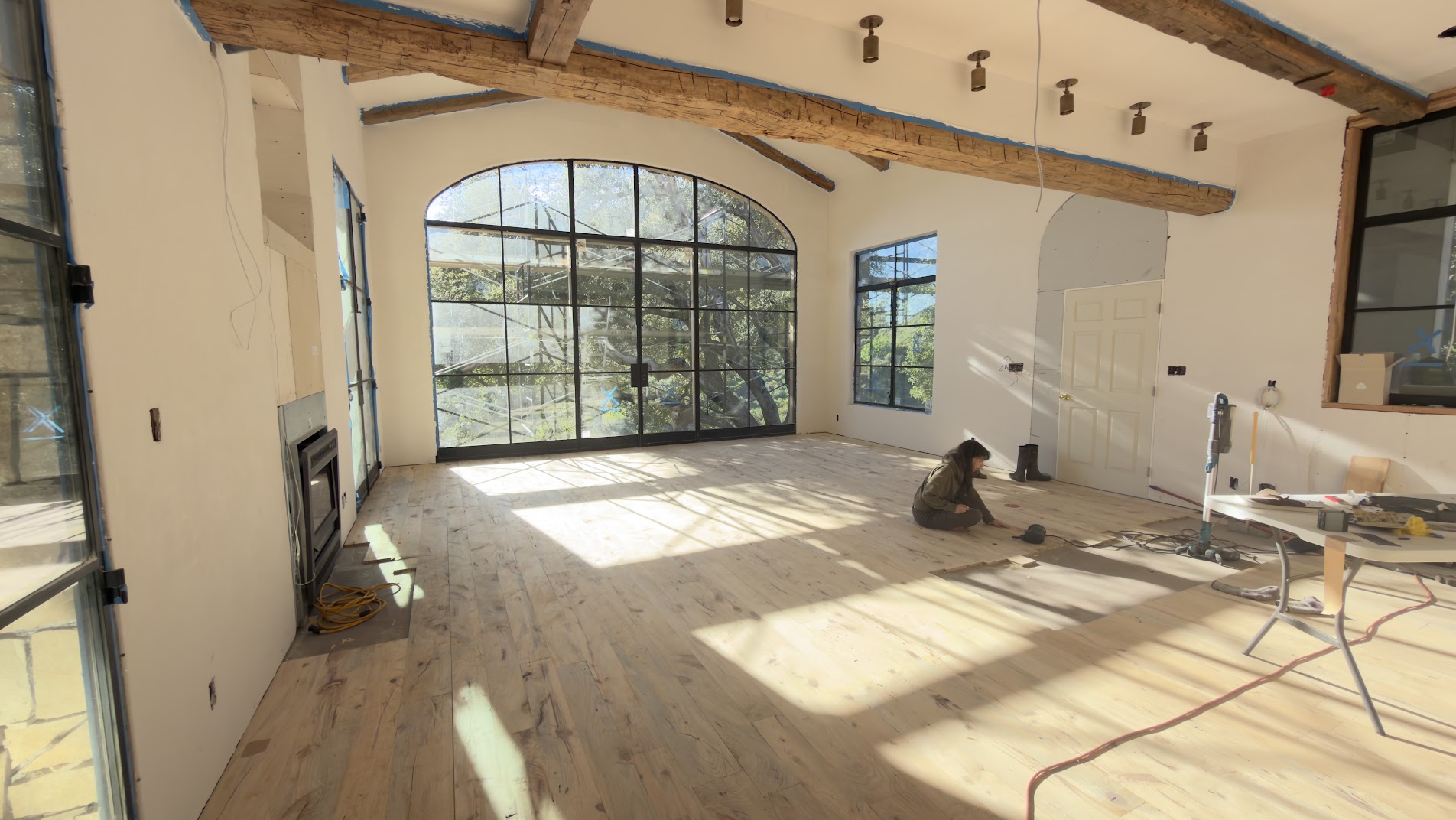

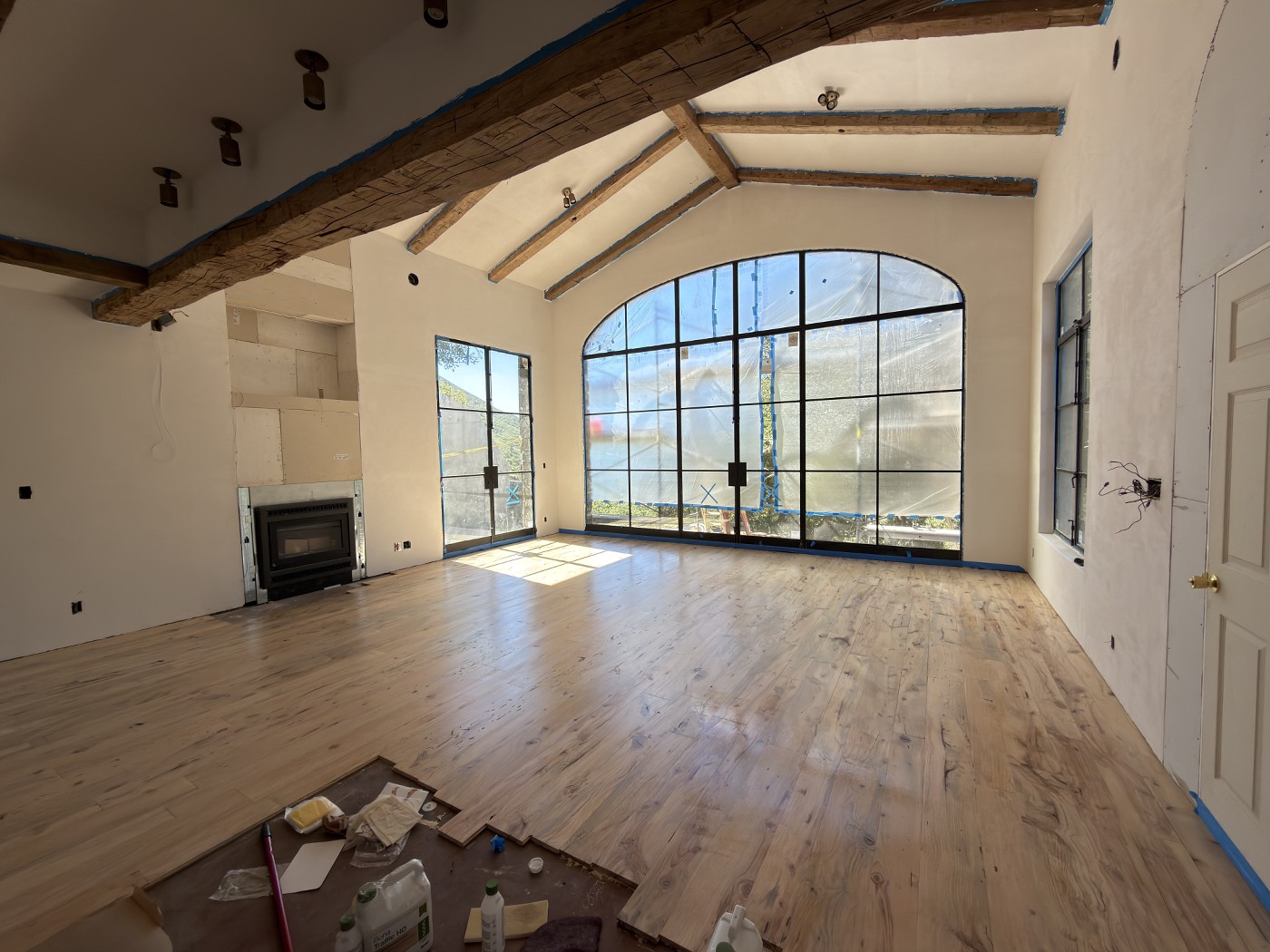

Finally, by the end of February, we were ready to sand, seal with two coats Bona Natural Seal, and finish with a coat of HD Traffic Satin.

Walking on these floors feels fantastic. So does napping, according to our dogs. But we will have to wait for more of that because we soon had to cover all the flooring with Ram Board to protect it during final finishes.

Rainy Day Blues!

We love the rain….. Our Dogs?
Not so much

March 2026 | The Gate and the Pillar

In September 2025, we reached a major milestone – getting our gate back, now expanded to meet fire code.

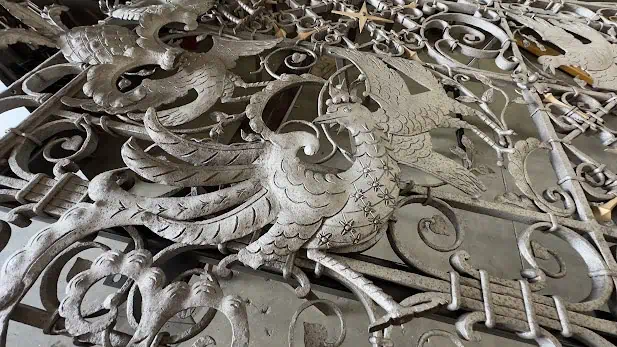

The original gate is the 10 feet in the middle, which we understand was originally from a Dole plantation in Hawaii (see the pineapple on top?).
Our metal artist Arturo Cruz of Cruz Metal Design did a beautiful job keeping its character while extending it to 15 feet to bring it into code compliance.
The original gate was rusty, and we let the new gate weather outside to regain its patina. An family friend tried to warn us that it was quickly losing its shine by being left outside, but we reassured him that this was intentional!

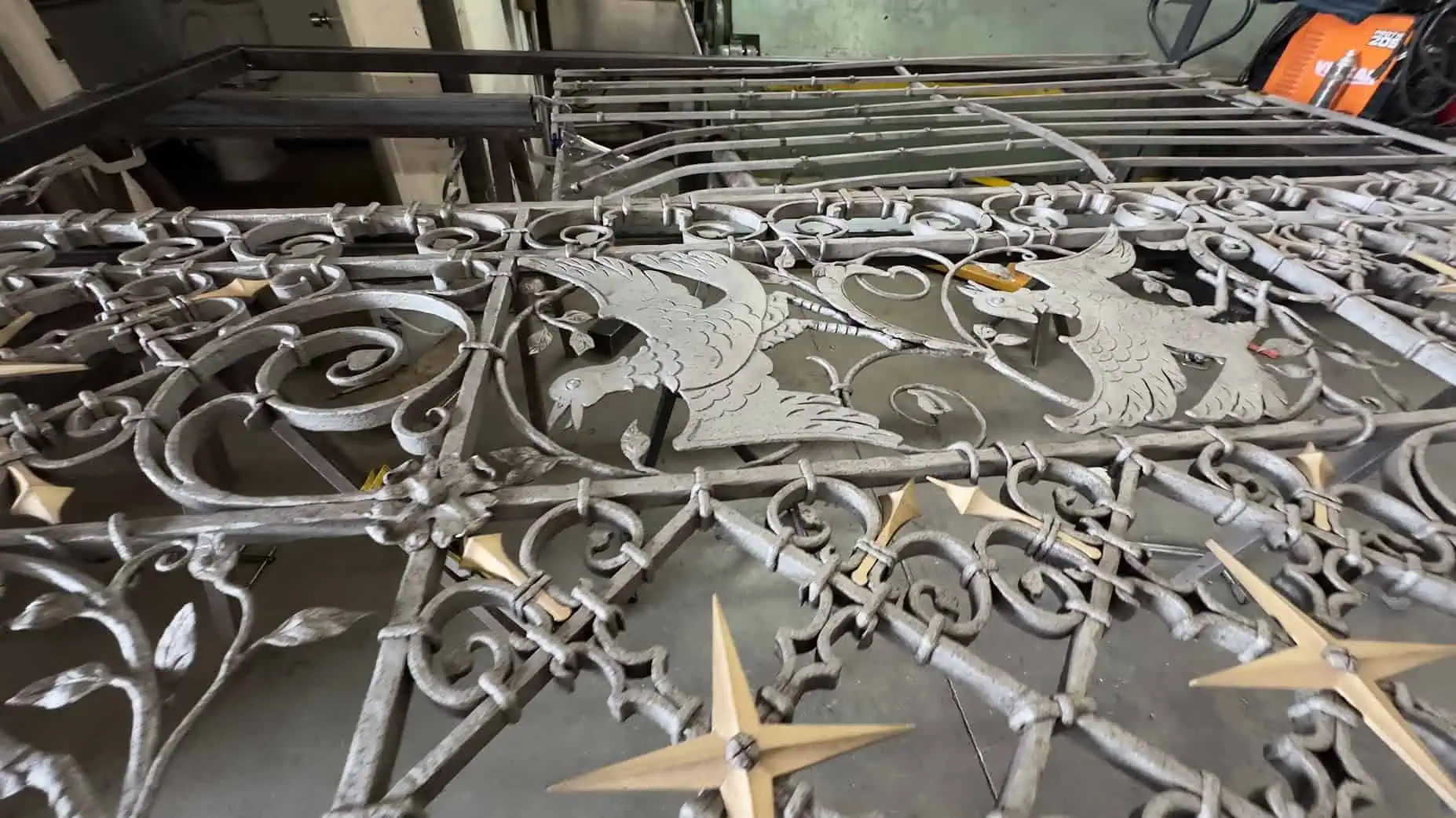

By early April, the gate was ready to install.

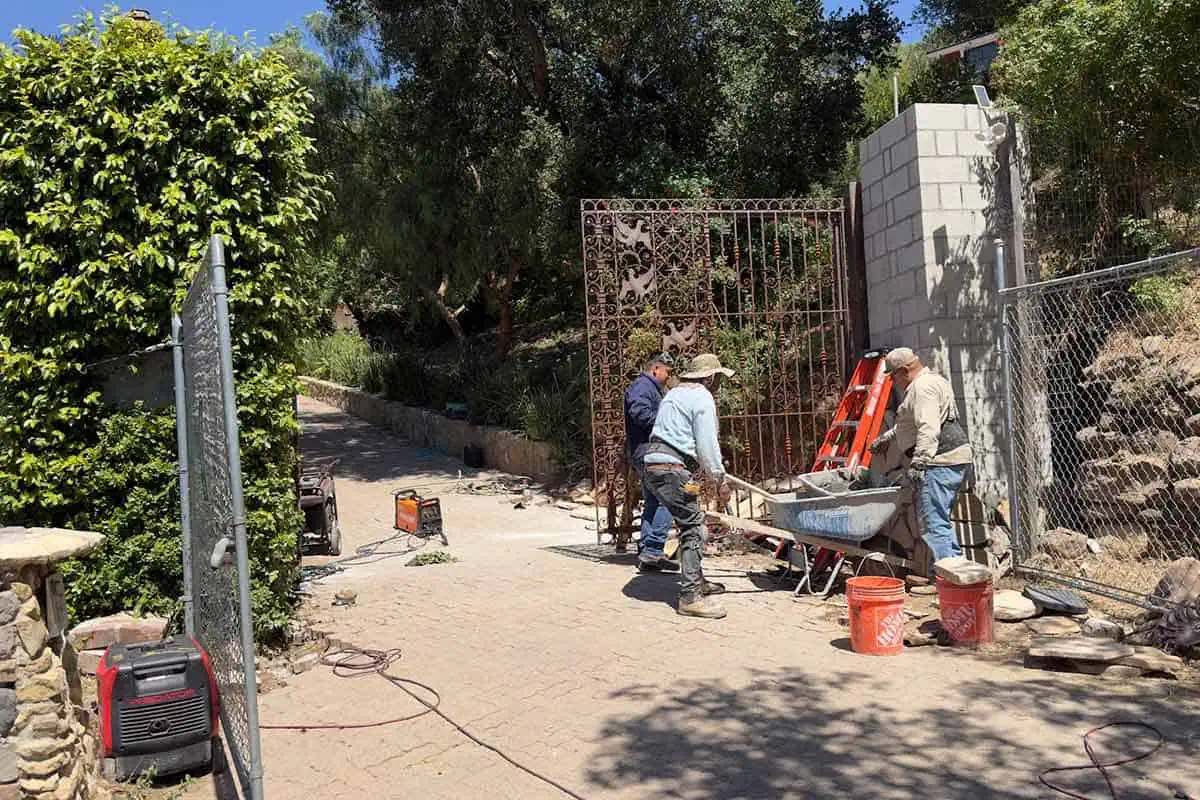

Next, our masonry crew re-added stone veneer on the re-constructed pillar that had been removed when we got the tiny house (see that saga from summer 2020). We had saved the stone from the old pillar, but the crew couldn’t find it! We started a long search to find a match for the old stone, making many calls and visits to one stone yard after another. Our great detective work ended up right back where we started, when we finally uncovered the old veneer – just enough to cover the front and one side. For the rest, we bought flagstone in a similar tone and texture.

With the pillar and gate installation complete, next we need to motorize the gates and put in the new intercom. Now that’s a whole other story…
